|
THE CISTERN
Construction of the cistern
turned out to be the biggest surprise of the year. I had absolutely no idea of the
work involved in this thing when I began, and it's probably a good thing. I might
not have had the courage to take the first step if I'd had any idea what lay in store for
me.
First, I had my good friend Leroy bring
his giant front-loader to the lot and dig a gaping hole in the ground. That hole was
about 5' deep and 30' on a side. In the process, he pulled a few rocks out of the
ground that were larger than some cars I've seen. With the front-loader he had to
leave a ramp into the hole to bring the loader out, so I still had a lot of digging to do
after he finished. Next, I rented a backhoe from Obie to try to square off the hole.
That was an exciting adventure, to say the least. I got hopelessly mired in
the loose sand which had been stirred up by the front-loader...nearly tipped the backhoe
over several times...and eventually convinced myself that my calling in life was not to be
a heavy equipment operator. Nevertheless, a full afternoon of clumsy fumbling left
the hole a little flatter on the bottom and without a ramp leading down into it.
After that, the task fell to the tools
of last resort: shovel, rake, and hoe. I spent over a week at the bottom of
"the pit" trying to rake it smooth and level. Naturally, the sun was
blazing hot and there was no air movement at the bottom of the pit. At the end of
the week it looked reasonable to me--"good enough" is the phrase that comes to
mind. Then I turned to building a form for the cistern base. I wanted to pour
the concrete 6" thick, so I used 2" x 8" lumber to make the form.
This had to enclose an area 22' long x 20'-8" wide, and at this point I was still
trying to do all my level checks with a 6' carpenter's level. Big mistake! It
would have been ever so much easier if I had bit the bullet and made a water level right
then. But I didn't, and eventually I convinced myself the form was level.
After the form was down, I went to work
on my radio ground. I had brought 200' of #4 copper wire, so I snaked that wire
around inside the form, then put in three 8' copperclad steel rods for good measure.
On top of the wire went a layer of plastic, and then the rebar. I used #4 rebar
(1/2" diameter) and ran it both directions spaced 1' apart. At that point, the
form was ready to pour...almost. First, I needed to stage all the materials we would
need during the pour.
By way of background, I had been
cautioned that the first course of concrete blocks had to be set into the concrete when it
was still wet. The purpose of this is to ensure there is no leak underneath the
blocks. Unfortunately, though, the only blocks I was able to find in Tampa had flush
ends; I couldn't locate any stretcher blocks. With the flush ends, I would be unable
to seal the gaps between the blocks after they were set. This problem was solved by
buying 78 stretcher blocks there on the island--at $3.12 apiece. (Blocks in Tampa
went for $.85.) It took several trips with the van, but eventually I had all 78

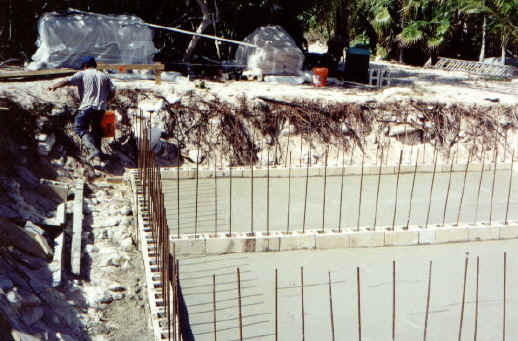

blocks laid around the outside of the form so we could set them in the wet concrete.
Next, I cut 154 pieces of rebar about 5' long, and laid those around the edge of
the pit. The plan was to put the rebar into the cores of the blocks and down into
the concrete...again, before the concrete set.
The big day for the giant pour was
December 1, and it's a day I'll long remember. I scoured the island trying to find a
helper, and finally convinced one of the few Caymanians on the island to help me for a few
hours. Jimmy saved my neck on this project, since it would have been impossible for
me to do the pour alone. The truck showed up at 8 a.m., and by noon all 8 cubic
yards of concrete (at $250/cu. yd.) was so hard we couldn't work it any more. We did
manage to get all of the blocks into the concrete in something that only remotely
resembled a sequence of straight lines; the rebar went into the holes at about the last
moment possible. It wasn't much of a finishing job, I'm afraid, and there are
distinct undulations.

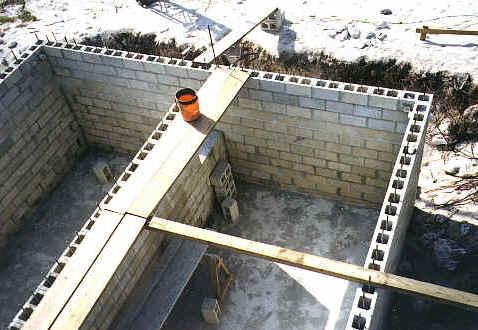

After going around that first course and
filling in all the gaps with mortar, I started [attempted] to lay blocks. I had done
some minor brickwork when I was 12 years old in order to earn the Boy Scout
"masonry" merit badge, so I actually thought I knew what I was doing when I
started this phase. That turned out to be a joke! I didn't have a clue how
much water to mix into the mortar, and I suspect I was placing as much mortar with my
fingers as I was with the trowel. I was going nowhere, but fortunately a savior
dropped by one day to see how I was doing. That was Marvin, my old landlord from a
previous stay on Little Cayman. Marvin had been a builder in Alaska, and he had
done this stuff before. Marvin jumped down into the pit with me and gave me a
demo. I kept telling him I still didn't get it, and encouraged him to lay a few more
blocks just to show me how it was done, but eventually he said "enough".
His parting words were that I should be able to start off laying 100 blocks per day, and
in no time at all I would be doing 400 blocks a day.
Right. I actually believed
him. Simple arithmetic said the whole cistern would be done by Christmas. I
plunged into it, and slowly...slowly...the blockwork started to look a little
better. I still couldn't seem to get the blocks quite level, and the courses were
not always straight, but at least there was progress being made. Never once did I
get more than 30 blocks laid in a single day. I had to begin each day by working out
on the giant sand pile Leroy had built when he excavated the hole. The
sand/rock/gravel/coral mess had to be shoveled against a large screen I built early in the
project. With luck, I got clean sand out of the other side of the screen. In
about 30 minutes, if I worked at it, I could get one wheelbarrow load of sand. Then
I mixed the mortar in the trusty Red Lion mixer I had bought in Tampa--3 big coffee cans
worth of sand, one coffee can worth of cement, and about half a can of hydrated
lime. Add water, mix, and voila! Mortar. I dumped the mortar in a
bucket, lugged the bucket down into the pit, dumped it on my mortar board and went to
work. In the best of times, I could lay 7 blocks with that batch of mortar.
Total elapsed time from when the water hit the cement in the mixer until I had cleaned up
from the batch was about 2 hours.
By Christmas, when I thought I should
have been done with the whole project, I was only up to the seventh course. There
were a total of 12 courses needed to complete the blocklaying. That was when Wesley
came down to visit for a couple of weeks, and the break from work was fantastic. We
actually got to go diving! Wesley could see that mid-April was but a dream, though,
so she delivered stern warnings that I should hire somebody to help me in order to get
back to California on time.
Eventually I did manage to hire a
helper. That was Johnny, a retired merchant sailor. Johnny was
fantastic. He sifted sand, carried blocks for me, kept me supplied with mortar, and
still had time to spare. The only problem was that Johnny worked for one week (at
$16 an hour) and then decided he didn't want to work any more. That one week was
enough to get me closer to the finish line, though, and by the end of January I laid the
last block on the cistern. What an ordeal! I felt there should have been a
band playing when that last block went down, and maybe even a press photographer to record
the grand moment. There was only the roar of the surf to applaud the effort, and
then it was time to move on to the next phase.
The next effort involved pouring
concrete into each of the cores in the wall. What I learned is that in reality a
concrete block is nothing but a miniature concrete form. By itself, the block is
fragile as fine glass. (I'm no longer impressed by Karate experts smashing blocks to
demonstrate their strength; I did it all the time without even trying!) The block
structure gains its strength by filling the cores with concrete and running rebar through
the core. So all that was needed was to mix a bunch of mortar, dump it in a bucket,
and then go pour the bucket down the core. It was a simple project, until you
consider the scale. Each bucket of mortar weighed about 80 pounds, and it took 3
full buckets of mortar to fill one core. Roughly speaking, a core full of concrete
is a pile 5" x 5" x 7'. There were 154 such cores to be filled.
That's a lot of concrete to carry by hand. Worse, it was a lot of sand to sift by
hand. I truly wondered whether even convict labor had ever been sentenced to a
punishment as severe as the time I spent on the sandpile sifting sand. Moreover, I
finally worked my way down the pile of cement bags to a point that I discovered the Little
Cayman termites had decided to feast on the paper bag material. They not only ate
through the outer paper on each bag of cement, but then penetrated the plastic lining to
eat the paper on the inside of the bag. Some of the bags were so deteriorated that
I dared not try to pick up the bag and carry it over to the mixer, but had to cut it open
in place and scoop up the cement from there. By early February I had finished

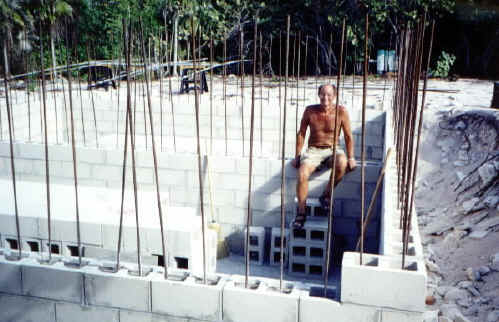

this whole job, and the picture of the top of this page was taken the day I poured my last
of the 450+ buckets of mortar down the hole.
After that, I had to plaster the inside
of the cistern. One of the purchases I had made in Tampa was a brand of swimming
pool plaster called "Krystalkrete". I had bought 80 bags of this stuff, at
80# per bag, and shipped it in the containers with the rest of my materials.
Unloading that stuff back in October felt like a breeze after unloading the 94# bags of
cement. Still, it was a formidable pile to tackle as I began working with it.
This stuff turned out to be treacherous. The manufacturer must not have had very
accurate process control when it was mixed, because some of the bags set quickly after
they were mixed. More than once I got a bucket down into the cistern and then
discovered it had set even before I could dump the bucket out. Once it even set on
me between the time I turned off the mixer and the time I went to dump it into the
bucket! It was just like working with epoxy--it would be liquid one minute and
completely rigid the next.
I mixed a whole bag at a time, and the
combination of plaster mix, water, and the bucket itself was very close to 100#.
With just a thin wire handle on the bucket, it was more than I could carry down a
stepladder into the cistern. Fortunately, I was able to borrow a boat davit and

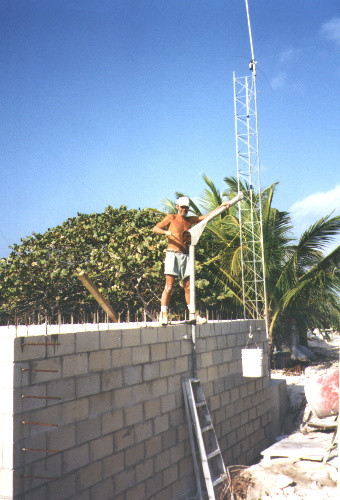

hoist the buckets down into the cistern with the davit. The middle picture on this
page shows the process. Two coats of plaster went on both the sides and the bottom
of the cistern; each coat was about 1/4" thick. In the process, I learned yet
another of my skill limitations: I cannot plaster. Yes, I got it on the
walls, and I did sort of smooth it out and made sure it covered any potential leak
point. But I'll have to say I'm glad the result isn't exposed to public view.
One problem is that I had to do this in batches. I mixed a bucket, took it down into
the cistern, applied it, and then went back up to mix another bucket. By the time I
came down with the next bucket, the previous load had set so much that it was impossible
to feather in the new mix with the old. I can still see the bucket boundaries on the
cistern wall today!
The Krystalkrete phase ended in late
February, and then I went to work on the ceiling. This was a task that had worried
me from the very beginning of the project, since I knew I didn't know what I was
doing. The two questions I kept asking were how to build a form strong enough to
hold 40,000 pounds of concrete up in the air while it was curing, and how to design the
ceiling pour so that it would stay up after it cured and the forms were removed. I
sought advice from others on the island who had been there and done that, and that saved
me. It was indeed a lot of form work, but it was fun to be working with wood for a
change. By the end of February I had the form in place and all the rebar cut and
tied together. This time I used #5 rebar (5/8" diameter) and again ran it
12" apart in both directions, just as I had done on the floor of the cistern.
The form was set for a 6" slab on the ceiling.
Again I scoured the island trying to
find a helper for the big pour coming up, but this time Johnny couldn't help me.
Eventually I persuaded another fellow to take a day off from his job and work with me for
the morning--for a price, of course. Philip showed up bright and early at 8 a.m. on

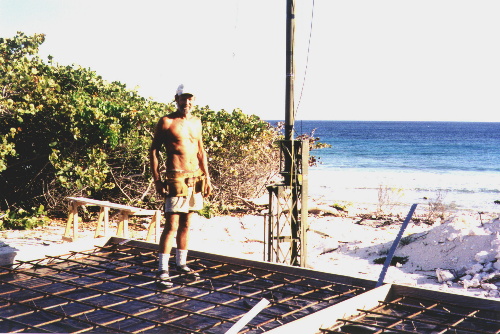

the big day, and jumped right in (pun intended). Our biggest problem was that the
ceiling of the cistern was too high for the concrete truck, so the concrete just sat in
the trough when it came out of the mixer. It didn't flow down the trough at
all. Consequently, we had to push it down the trough with a shovel, then push the
concrete the 20' or so it had to go to get to the other side of the cistern. Yes, we
had to push all 40,000 pounds of it around. That was another day I would just as
soon forget. It was broiling hot, and at one point I got so desperate for a drink of
water that I grabbed Philip's water jug instead of going for my own. Big
mistake: it was pure gin instead of water. Philip is a 24 hour a day party
animal, even when pouring concrete.
The last and final touch on the cistern
was to stucco the outside of it before backfilling sand into the hole. Here, I
finked out completely. Experience had taught me that I could not do plaster
work--and that also includes stucco. I managed to work a deal with a builder on
Cayman Brac to send over a crew of Jamaicans to do this job for me. They actually
made it look easy, but I know better. In only three days time they had the entire
job done, and the result hid all the imperfections of my blocklaying. I think the
cost to me worked out to about $600 per Jamaican per day. I just hope those poor
guys got some of that, because they certainly earned it.
Leroy then came back with his backhoe
and backfilled the cistern. Once we filled in the pit around that cistern it didn't
look quite so big any more. He spread what was left of my sand pile around and did
final grading. I breathed a short, small sigh of relief, because now I could move on
to another project. Unfortunately, that was more concrete work. It was by
then March 23--about 3 weeks short of the day I had originally thought I would be through
with the roofing and ready to go back to California. |

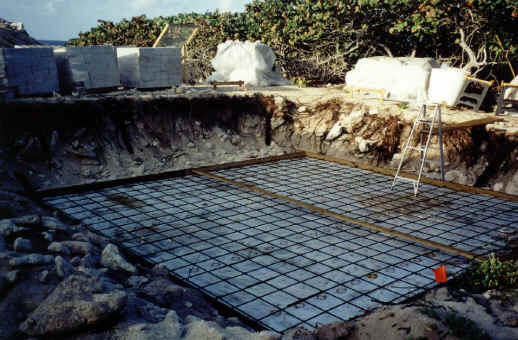

 November 30, 1998: Almost ready for the cistern base to be
poured. The radio ground snakes around under the plastic inside the form. |
